Epic Lead Time

Epic Lead Time

Understand the bottlenecks in your planning process by looking at your Epic Lead Time phases

Overview

Epic Lead Time is defined as the median epic duration, which is calculated as the difference in time from when the epic is created, through to when the epic is closed. This is calculated week over week by when the epic is closed and plotted in the trendline. The top level metric is the median of all epics that were closed within the time range set by the time picker.

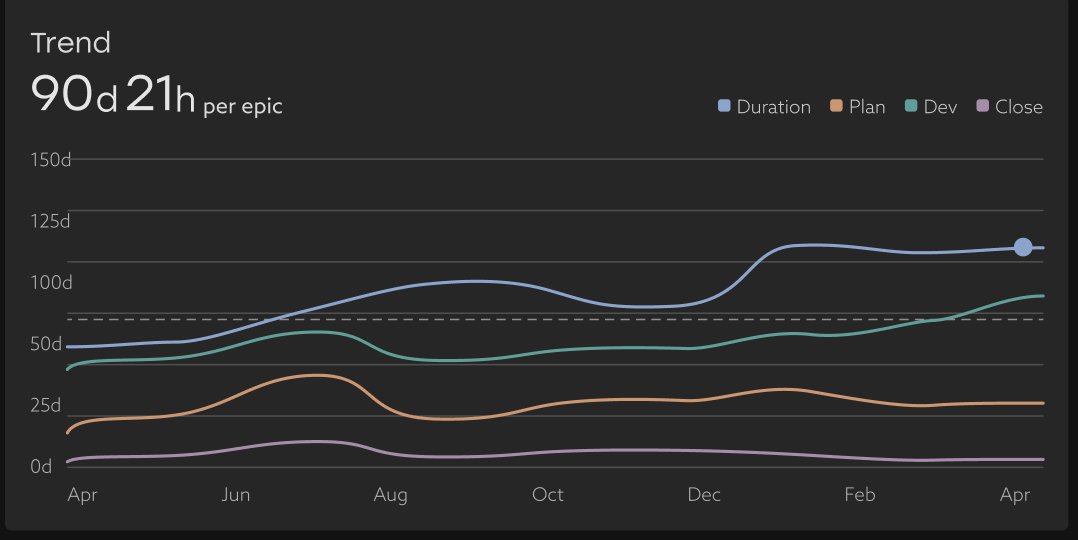

Untitled

The time is broken down into three components:

Notes
  • Plan: the duration of time between when the epic is created and when the first development action takes place (e.g., a work item moves to In Progress or a PR is created that is linked to an issue in the epic).
  • Dev: the duration of time from the first activity through to the last development activity (e.g., a work item closes or final PR activity)
  • Close: the duration of time from the last development activity to when the Epic is closed.

Epic Lead Time by Phase

For all epics that were closed within the range selected in the time picker, this metric calculates the median Plan, Dev, and Close Durations. This data can help organizations get a sense of which phase of development is taking the longest time.

Untitled (1)

Idea
  • If Plan is the longest, it could indicate that creating requirements takes more time than expected, or that the engineering team has such a long backlog that they don’t get to the work until later than expected.
  • If Dev is significantly longer than expected, it could mean that the requirements were unclear, requiring back and forth between Product / Design / UXUI / etc., to scope out what is actually to be built.
  • If Close is longer than expected, this could indicate that there are some final trailing blockers or items that are preventing the team from simply closing out the epic.

Breakdown

Epics can have significantly varying size and effort. This table helps to give context for what could delay an epic in any of the phases described above.

Untitled (2)

The table breaks down:

  • Duration: the duration of time between epic creation and the epic being closed, as well as the three phases described above
  • Effort: this metric leverages Uplevel’s Time Allocation insights to compute how much development effort went into a specific epic while it was open.
    • Example 1: One developer who spends 50% of their time in meetings, and all of their available working time on this project for a week would contribute 0.5 dev weeks of effort.
    • Example 2: A 5-person scrum team with on average 70% available development time working for 10 weeks on an epic would contribute (0.7 x 5 devs x 10 weeks) = 35 dev weeks of effort to this Epic.
  • Add-on - this metric also leverages Uplevel’s Time Allocation insight to compute how much development effort went into a specific epic after it was closed. This can help scope how much long-tail effort went into an epic that was already ‘finished’.

Key questions to ask using this data

  • How long does it really take to plan and deliver a new feature?
  • Are there bottlenecks in our planning or development process that make this process slower than it needs to be - perhaps because of unclear requirements
  • Are we speeding up or slowing down in delivering our commitments?
Idea

Tip:

Look to the Effort and Add-On columns to understand the context of long running epics. It may be that the epic was simply a very large body of work that took a lot of effort to complete - or maybe it was a small body of work that was continually deprioritized in favor of other initiatives.

Open Epics

The above metrics focus entirely upon Epics that were closed within the duration of time selected with the time picker. However it can also be useful to see what other Epics are currently open and in-flight.

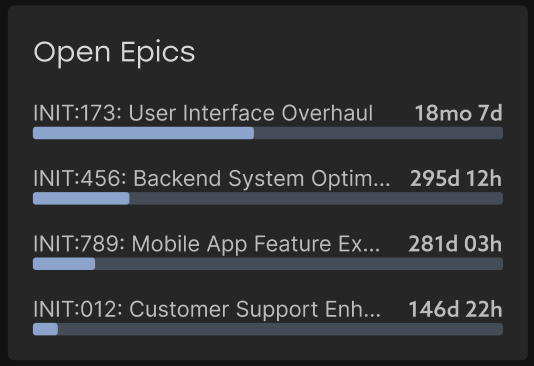

Untitled (3)

Some may be ongoing epics that are used to capture work that never has a finite end, like a “Customer Support” epic or “General Bugs and Polish." Others are epics that are currently in progress in one state or another. This can help give a sense of what a specific set of people are currently working on (and even suggest places to do some clean-up efforts).

Frequently Asked Questions (FAQ)

  1. Why is X Epic showing for this team?
    An epic will appear for a team or teams if any individual IC on that team had effort towards an epic. For some highly cross-functional teams, this may be a small bit of effort across many epics. To gain further insight around this, we recommend heading over to the Plan page to gain insight into what that team worked on during specific time periods.
